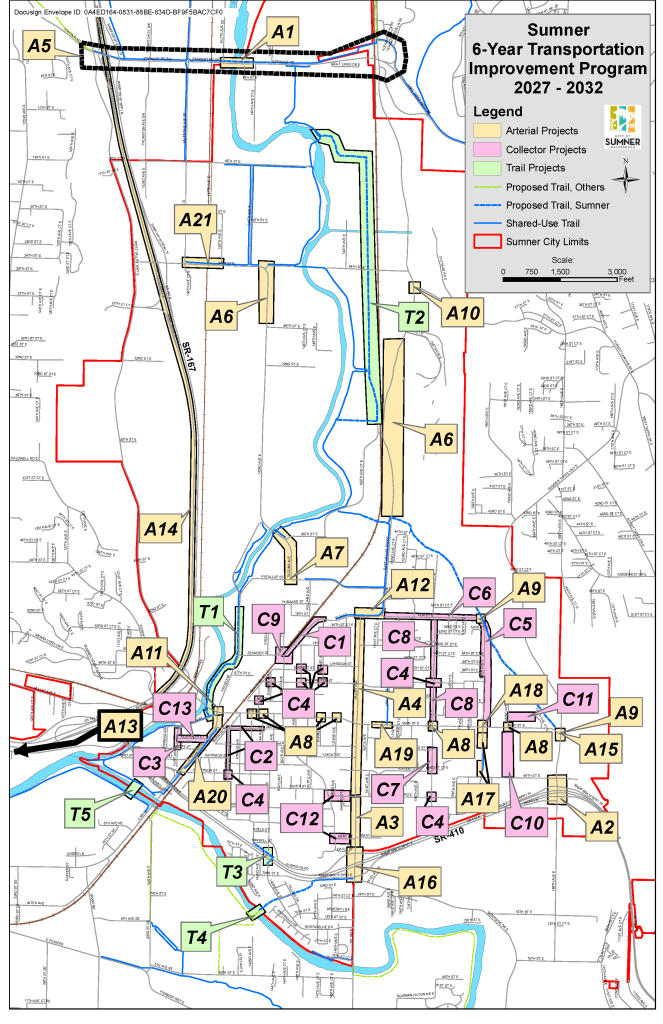

Every year, Sumner outlines its priority transportation projects for the next six years. Priorities may mean that a project needs attention for further study, funding or construction. By being on the plan, it also helps Sumner seek grant funding for these projects. Together, they help the City keep Sumner’s traffic and pedestrians moving.

Arterials

A1 – Stewart Rd (8th St.) White River Bridge

Replace existing 2-lane bridge with new bridge with two unequal length spans. New structure will accommodate 4 vehicle lanes, a sidewalk, and a trail crossing.

  • Click here for full project page
  • Location: Stewart Road at White River
  • Total Cost: $35,000,000
  • Funded: Yes
  • Planning: Complete
  • Design: Complete
  • ROW/Permit: Complete
  • Construction: 2025-2028
  • Remarks: Project funded by Federal STP Grant, FMSIB Grant, Pierce County, Port of Tacoma, TIB, Congressional Allocation, NHFP and City of Auburn.

A2 – 166th Ave E Widening

Widen 166th Ave E to 4-5 lanes through the identified corridor and improve lane configuration and dual roundabouts at the two existing intersections.

  • Click here for the full project page.
  • Location: SR 410 WB Ramp Terminals to just north of 64th St E
  • Total Cost: $18,000,000
  • Funded: Partial
  • Planning: Complete
  • Design: 2027
  • ROW/Permit: 2027
  • Construction: 2029-2031
  • Remarks: Design is City funded, received a Port of Tacoma Grant and a federal STP grant. Received a federal STP grant for the ROW phase.

A3 – Valley Avenue Overlay Phase 1

Overlay existing roadway surface, complete required ADA upgrades.

  • Location: South City Limits to Meade McCumber Rd E
  • Total Cost: $1,200,000
  • Funded: Yes
  • Planning: Complete
  • Design: Completing in 2026
  • ROW/Permit: N/A
  • Construction: 2027
  • Remarks: Received STP grant funding for the section between SR 410 and Meade McCumber.

A4 – Valley Avenue Overlay Phase 2

Overlay existing roadway surface, complete required ADA upgrades.

  • Location: Meade McCumber Rd E to Elm St
  • Total Cost: $4,500,000
  • Funded: Partial
  • Planning: Complete
  • Design: 2028
  • ROW/Permit: N/A
  • Construction: N/A
  • Remarks: Received grant funding for the design phase of this project.

A5 – Stewart Rd Corridor ITS Improvements

Connect traffic signals and the railroad crossing to coordinate signal timing to increase vehicular traffic flow and reduce peak-hour delay.

  • Location: Stewart Rd from SR 167 toward Lakeland Hills
  • Total Cost: $3,500,000
  • Funded: Partial
  • Planning: Complete
  • Design: 2027
  • ROW/Permit: 2027
  • Construction: 2029
  • Remarks: Received STP grant funding for design in 2025.

A6 – Systemic Horizontal Curve and Roadway Departure Safety Improvements

Install curve warning signs, speed feedback signs, rumble strips, profiled striping, reflective markers, guardrail, street lighting and shouldering to improve safety conditions on north-south roadways that have a history of vehicle departures.

  • Location: East Valley Highway and 142nd Ave E
  • Total Cost: $903,000
  • Funded: Yes
  • Planning: Complete
  • Design: Completing in 2026
  • ROW/Permit: N/A
  • Construction: 2027
  • Remarks: Received HSIP funding to complete the project, reimbursing 100% of project costs.

A7 – Puyallup St and Tacoma Ave Intersection Improvements

Upgrade intersection to a roundabout and provide sidewalks/ADA improvements.

  • Location: Intersection of Puyallup Street and Tacoma Avenue
  • Total Cost: $2,600,000
  • Funded: Partial
  • Planning: Complete
  • Design: 2029
  • ROW/Permit: 2030
  • Construction: 2031
  • Remarks: Received STP grant funding for design. Seeking grant funding for the construction phase of the project.

A8 – Main Street Crossings

Upgrading intersections along Main St with curb bulb outs, flashing beacons, and refreshed crosswalk markings.

  • Location: Intersections of Alder Ave & Main St, Ryan Ave & Main St, Bonney Ave & Main St, Lewis Ave & Main St, Parker Rd & Main St, and 60th St E & 162nd Ave E
  • Total Cost: $979,740
  • Funded: Yes
  • Planning: Complete
  • Design: Completing in 2026
  • ROW/Permit: 2026
  • Construction: 2027
  • Remarks: Received TIB grant funding for design and construction. Grant will cover 76% of project costs.

A9 – Roadway Curve Warning & Delineation

Install signing and striping improvements, raised median, and speed feedback signs.

  • Location: Corner of 160th St E and Elm St E, and corner of 60th St E and Sumner-Tapps Highway E
  • Total Cost: $457,000
  • Funded: Yes
  • Planning: Complete
  • Design: Completing in 2026
  • ROW/Permit: N/A
  • Construction: 2027
  • Remarks: Received HSIP funding to complete the project, reimbursing 100% of project costs.

A10 – East Valley Hwy and Forest Canyon Rd E Intersection Improvements

Upgrade the intersection to a roundabout to improve function.

  • Location: Intersection of East Valley Highway and Forest Canyon Road
  • Total Cost: $8,560,000
  • Funded: No
  • Planning: Complete
  • Design: 2029
  • ROW/Permit: N/A
  • Construction: 2031
  • Remarks: This is a future project that will be evaluated in the coming years. Potential for partial funding through TIF.

A11 – Traffic Avenue and Main Street Intersection Improvements

Upgrade the signalized intersection to improve function.

  • Location: Intersection of Traffic Ave and Main St
  • Total Cost: $15,000,000
  • Funded: No
  • Planning: 2027
  • Design: 2029
  • ROW/Permit: 2031
  • Construction: 2033
  • Remarks: This is a future project that will be evaluated in the coming years. Potential for partial funding through TIF.

A12 – East Valley Hwy/Elm St./Valley Ave Intersection Improvements

Upgrade the intersections to roundabouts to improve function.

  • Location: Intersection of East Valley Highway and Elm Street and the intersection of Valley Avenue and Elm Street
  • Total Cost: $14,992,000
  • Funded: No
  • Planning: Complete
  • Design: 2031
  • ROW/Permit: 2033
  • Construction: 2035
  • Remarks: This is a future project that will be evaluated in the coming years. Potential for partial funding through TIF.

A13 – SR 167 / I-5 Connection Project

WSDOT Gateway Program Project. The SR 167 Completion project will build the remaining four miles of SR 167 between Meridian and I-5, completing a long-planned connection to I-5. The project also includes a two mile connection from I-5 to the Port of Tacoma.

  • Location: Puyallup to Fife
  • Total Cost: *$1,000,000,000
  • Funded: Yes
  • Planning: Complete
  • Design: Complete
  • ROW/Permit: Complete
  • Construction: 2019-2030
  • Remarks: WSDOT-led regional project. Sumner committed $500,000 to the project in 2023.

A14 – SR 167 Southbound Express Toll Lane Extension Project

Add southbound HOT lane.

  • Location: From SR 512 to Ellingson Road
  • Total Cost: $350,000,000
  • Funded: No
  • Planning: Complete
  • Design: 2027
  • ROW/Permit: N/A
  • Construction: 2031-2035
  • Remarks: This is a WSDOT-led project on a state highway. Sumner has not taken an active role in WSDOT’s project and has not committed any funds to the project to date.

A15 – Sumner Tapps Highway/60th St E Intersection Improvements

Rebuild existing intersection to improve roadway geometrics to increase allowable movements.

  • Location: Sumner Tapps Highway and 60th St E Intersection
  • Total Cost: $3,400,000
  • Funded: No
  • Planning: 2028
  • Design: 2030
  • ROW/Permit: 2031
  • Construction: 2033
  • Remarks: Potential for partial funding through TIF.

A16 – SR 410 / SR 162 Interchange Improvements

Construct a one-lane roundabout configuration at each of the interchange ramps.

  • Location: Interchange ramps at SR 410
  • Total Cost: *$6,650,000
  • Funded: Yes
  • Planning: Complete
  • Design: Complete
  • ROW/Permit: Unknown
  • Construction: Unknown
  • Remarks: WSDOT-led project that will improve traffic flow at the existing interchange. Sumner has not taken an active role in WSDOT’s project and has not committed any funds to the project to date.

A17 – 160th Ave E

Improve and widen streets to minor arterial standards with bike paths and sidewalks.

  • Location: Main St to 64th St E
  • Total Cost: $5,000,000
  • Funded: No
  • Planning: Complete
  • Design: 2031
  • ROW/Permit: 2033
  • Construction: 2035
  • Remarks: Installing sidewalk on west side of 160th.

A18 – Main Street and 160th Intersection Improvements

Evaluate intersection and provide sidewalks/ADA improvements.

  • Location: Main St. and 160th Ave E Intersection
  • Total Cost: $8,000,000
  • Funded: No
  • Planning: 2029
  • Design: 2030
  • ROW/Permit: 2033
  • Construction: 2035
  • Remarks: This is a future project that will be evaluated in the coming years.

A19 – Main St Crosswalk Improvements

Evaluate warranted pedestrian crossing facilities in the vicinity of the new library.

  • Location: Main St. near new Library
  • Total Cost: $50,000
  • Funded: No
  • Planning: 2027
  • Design: N/A
  • ROW/Permit: N/A
  • Construction: N/A
  • Remarks: This is a study only and will determine future needs.

A20 – Traffic Avenue ITS Improvements

Connect traffic signals to coordinate signal timing to increase vehicular traffic flow and reduce peak-hour delay.

  • Location: SR-410 to Main Street
  • Total Cost: $1,500,000
  • Funded: Partial
  • Planning: 2029
  • Design: 2030
  • ROW/Permit: 2031
  • Construction: 2032
  • Remarks: This is a future project that will be evaluated in the coming years.

A21 – 24th St E Reconstruction

Reconstruction of 24th St E to adjust grades near UPRR Crossing.

  • Location: 136th Ave E to 138th Ave E including UPRR Crossing
  • Total Cost: $6,000,000
  • Funded: No
  • Planning: 2030
  • Design: 2032
  • ROW/Permit: 2034
  • Construction: 2036
  • Remarks: This is a future project that will be evaluated in the coming years.

* Denotes that project is largely funded by WSDOT, and City has either committed a small percentage contribution or no contribution to date.

Collectors

C1 – Elm St & Wood Ave Sidewalks

Extend the sidewalk on the north side of Elm Street and the West side of Wood Avenue.

  • Location: Bonney Ave to Zehnder St
  • Total Cost: $4,000,000
  • Funded: Partial
  • Planning: Complete
  • Design: 2028
  • ROW/Permit: N/A
  • Construction: 2030
  • Remarks: Received CMAQ grant funding for the design.

C2 – TC: Cherry & Maple Utilities

Replacement of aging utilities in support of the Town Center Plan redevelopment.

  • Location: Cherry Ave, Maple St
  • Total Cost: $3,000,000
  • Funded: Yes
  • Planning: Complete
  • Design: 2032
  • ROW/Permit: N/A
  • Construction: 2033
  • Remarks: Budget includes roadway restoration.

C3 – Hunt Ave

Improve Hunt Ave to residential street standards with roadway improvements, curb, gutter and sidewalks on each side. Portions have been completed by developer projects.

  • Location: W Main St to dead end past Harrison St
  • Total Cost: $3,000,000
  • Funded: Partial
  • Planning: Complete
  • Design: Completing in 2026
  • ROW/Permit: 2027
  • Construction: 2028
  • Remarks: Construction is currently unfunded.

C4 – Neighborhood Traffic Calming and Intersection Data Collection

Conduct an intersection and traffic calming study including data collection.

  • Location: Intersections of Parker Rd E and Meade McCumber Rd E, Parker Rd E and Washington St, Cherry Ave and Thompson Ave, North St and Ryan Ave, Washington St and Sumner Ave, McMillan Ave and Washington St/Everett St, and Bonney Ave and Washington St/Everett St
  • Total Cost: $150,000
  • Funded: Yes
  • Planning: Complete
  • Design: Completing in 2026
  • ROW/Permit: N/A
  • Construction: N/A
  • Remarks: Received HSIP funding to complete the project, reimbursing 100% of project costs.

C5 – 160th Ave E

Improve 160th Ave. E. to Collector St. standards with curb, gutter and sidewalks on each side. Portions may be completed as parts of development prior to this time.

  • Location: Elm St to Main St
  • Total Cost: $2,700,000
  • Funded: partial by developers
  • Planning: Complete
  • Design: 2029
  • ROW/Permit: 2030
  • Construction: 2031
  • Remarks: Project partially completed by developers.

C6 – Elm St E

Improve Elm St. to collector street standards with curb, gutter and sidewalks on each side. Work will include storm drainage facilities and utility replacement.

  • Location: E Valley Highway to 160th Ave E
  • Total Cost: $2,400,000
  • Funded: partial by developers
  • Planning: Complete
  • Design: 2029
  • ROW/Permit: 2030
  • Construction: 2031
  • Remarks: Project partially completed by developers.

C7 – Parker Rd E

Construct curb, gutter and sidewalk on east side of the street.

  • Location: 62nd St to 63rd St
  • Total Cost: $250,000
  • Funded: Partial
  • Planning: Complete
  • Design: 2029
  • ROW/Permit: 2030
  • Construction: 2031
  • Remarks: Funding will likely come from a combination of developer-built improvements, Street and Storm funds.

C8 – Parker Rd E

Reconstruct Parker Rd to Collector Street standards with curbs, gutters, sidewalks, and drainage utilities. Portions have been completed by developer projects and sidewalk grants.

  • Location: From Main St to Elm St
  • Total Cost: $1,300,000
  • Funded: Partial
  • Planning: Complete
  • Design: 2032
  • ROW/Permit: 2034
  • Construction: 2036
  • Remarks: Funding will likely come from a combination of developer-built improvements, Street and Storm funds.

C9 – Zehnder St

Railroad Crossing Improvements to at-grade BNSF rail crossing.

  • Location: From Pease Ave to Wood Ave
  • Total Cost: $1,000,000
  • Funded: No
  • Planning: 2027
  • Design: 2030
  • ROW/Permit: 2031
  • Construction: 2032
  • Remarks: Identified Road-Rail conflict point where upgrades could be beneficial.

C10 – 162nd Ave E Segment Extension

Construct new 2-lane roadway section with sidewalks.

  • Location: 64th St E to 60th St E
  • Total Cost: $3,000,000
  • Funded: No
  • Planning: 2029
  • Design: 2030
  • ROW/Permit: 2031
  • Construction: 2032
  • Remarks: Element of East Sumner Neighborhood Plan, likely completed by development or LID.

C11 – 164th Ave Ct E Segment Extension

Construct new 2-lane roadway section with sidewalks.

  • Location: 162nd Ave E to 164th Ave Ct. E
  • Total Cost: $2,000,000
  • Funded: No
  • Planning: Complete
  • Design: 2030
  • ROW/Permit: 2031
  • Construction: 2032
  • Remarks: Element of East Sumner Neighborhood Plan, likely completed by development or LID.

C12 – Meade McCumber Rd E & Gary St Sidewalk Improvements

Complete the sidewalk gaps at these two locations.

  • Location: Wood Ave to Valley Ave
  • Total Cost: $650,000
  • Funded: No
  • Planning: Complete
  • Design: 2027
  • ROW/Permit: 2028
  • Construction: 2029
  • Remarks: This is a future project that will be evaluated in the coming years.

C13 – Elizabeth St

Improve Elizabeth Street to Residential Street standards with roadway improvements curb, gutter and sidewalks on each side. Portions have been completed with sidewalk grants and programs.

  • Location: Hunt Ave to Traffic Ave
  • Total Cost: $3,000,000
  • Funded: No
  • Planning: 2029
  • Design: 2031
  • ROW/Permit: 2032
  • Construction: 2032
  • Remarks: This is a future project that will be evaluated in the coming years.

Trails

T1 – Fryar Ave Trail

Complete trail connection through town.

  • Location: W Main St to Puyallup St
  • Total Cost: $9,000,000
  • Funded: Yes
  • Planning: Complete
  • Design: Completing in 2026
  • ROW/Permit: Completing in 2026
  • Construction: 2027
  • Remarks: Design and ROW partially funded by federal grant. Construction funded by WSDOT Bike & Pedestrian Grant.

T2 – White River Restoration Trail

Construct 10,000 LF trail in conjunction with restoration project.

  • Location: 45th Street to area north of 16th St
  • Total Cost: $3,000,000
  • Funded: Yes
  • Planning: Complete
  • Design: Completing in 2026
  • ROW/Permit: N/A
  • Construction: 2027
  • Remarks: Fully funded by restoration project.

T3 – Rivergrove Pedestrian Bridge

Construct trail bridge to provide a new trail connection between Sumner Town Center and the Rivergrove neighborhood over SR 410.

  • Location: Trail overpass connecting the vicinity of Alder Ave to 143rd Ave E
  • Total Cost: $12,200,000
  • Funded: Partial
  • Planning: Complete
  • Design: 2027
  • ROW/Permit: N/A
  • Construction: 2028
  • Remarks: Design funding provided by ST3 and CMAQ grants. Received partial construction funding from PSRC STBG grant.

T4 – Puyallup River Trail Bridge

Construct a trail bridge and trail connections to provide a connection to the Foothills Trail per the Sumner Parks and Trails Plan.

  • Location: Trail overpass connecting 144th Ave E to 143rd Ave E
  • Total Cost: $6,000,000
  • Funded: No
  • Planning: 2031
  • Design: 2032
  • ROW/Permit: 2033
  • Construction: 2034
  • Remarks: Identified in Draft Parks and Trails Plan. No funding source secured.

T5 – Puyallup River Crossing

Provides improved connection with the Puyallup and Foothills trail system.

  • Location: Sumner WWTP to Puyallup trail
  • Total Cost: $4,000,000
  • Funded: No
  • Planning: 2031
  • Design: 2032
  • ROW/Permit: 2033
  • Construction: 2034
  • Remarks: Potential joint project with Puyallup. Eligible for federal CMAQ funding.

Annual Street Maintenance Programs

These are ongoing programs with annual budgets, not discrete projects with typical project phases.

R1 – Street Overlay Program

Overlay and rebuild existing streets throughout the City.

  • Location: Throughout the City
  • Annual Cost: $167,500
  • Funded: No
  • Construction: Ongoing
  • Remarks: Street Operating General Fund Budget

R2 – Roadway Paint Line Application

Repaint lane lines throughout the City.

  • Location: Throughout the City
  • Annual Cost: $41,000
  • Funded: Yes
  • Construction: Ongoing
  • Remarks: Street Operating General Fund Budget

R3 – Pavement Repairs

Repair spot surface and subgrade failures through dig-outs throughout the City.

  • Location: Throughout the City
  • Annual Cost: $69,460
  • Funded: Yes
  • Construction: Ongoing
  • Remarks: Street Operating General Fund Budget

R4 – Roadway Plastic Marking Application

Replace crosswalk, stop bar, and arrow markings throughout the City.

  • Location: Throughout the City
  • Annual Cost: $58,905
  • Funded: Yes
  • Construction: Ongoing
  • Remarks: Street Operating General Fund Budget

R5 – Chip Seal Application

Apply a chip seal treatment to asphalt roads throughout the City.

  • Location: Throughout the City
  • Annual Cost: $250,000
  • Funded: Yes
  • Construction: Ongoing
  • Remarks: Street Operating General Fund Budget

R6 – Crack Seal Application

Maintain roads with crack seal throughout the City.

  • Location: Throughout the City
  • Annual Cost: $80,720
  • Funded: Yes
  • Construction: Ongoing
  • Remarks: Street Operating General Fund Budget

R7 – Neighborhood Traffic Control Program

Modify residential streets to enhance pedestrian safety, slow speeding vehicles, and minimize cut-through traffic on collector and local roadways.

  • Location: Residential streets
  • Annual Cost: $25,000
  • Funded: Yes
  • Construction: Ongoing
  • Remarks: Street Operating General Fund Budget

R8 – ADA Transition Plan

Address the projects identified in the ADA Transition Plan.

  • Location: Various locations per plan
  • Annual Cost: $40,000
  • Funded: Yes
  • Construction: Ongoing
  • Remarks: Sidewalks Construction Capital Fund Budget

R9 – Sidewalk Maintenance Program

Replace/rebuild existing failing sidewalks due to damage caused by street trees.

  • Location: Throughout the City
  • Annual Cost: $250,000
  • Funded: Yes
  • Construction: Ongoing
  • Remarks: Sidewalks Construction Capital Fund Budget

R10 – Helping Homeowners Sidewalk Program

Replace existing failing sidewalks as part of a 50/50 cost share with homeowners.

  • Location: Various residential locations
  • Annual Cost: $50,000
  • Funded: Yes
  • Construction: Ongoing
  • Remarks: Sidewalks Construction Capital Fund Budget

Transportation Projects Completing in 2026

Washington St Preservation

Re-construct Washington St with ADA compliant sidewalks, planter strips, curb bulbs, upgraded ADA curb ramps, paved street surface, and the replacement of underground utilities within the corridor.

  • Location: Washington St between Wood Ave and McMillan Ave
  • Cost: $2,818,000
  • Funded: Yes
  • Planning: Complete
  • Design: Complete
  • ROW/Permit: Complete
  • Construction: Completing 2026
  • Remarks: Project to be completed in 2026. Project was funded with City Council Reserves.

Maple St Pedestrian Signal and Citywide Signal Backplates

Replace existing pedestrian-activated rectangular rapid flashing beacons with signal, a High Intensity Activated Crosswalk (HAWK) signal, and add retroreflective backplates to upgrade signal heads citywide.

  • Location: Traffic Ave and Maple St Ped Signal, Backplates Various Locations Citywide
  • Cost: $1,080,508
  • Funded: Yes
  • Planning: Complete
  • Design: Complete
  • ROW/Permit: Complete
  • Construction: Completing 2026
  • Remarks: Project to be completed in 2026. Project is funded through an HSIP grant.

Contact Us

Public Works Department
1104 Maple Street, Suite 260, Sumner WA 98390
253-299-5700      FAX 253-299-5539
pw@sumnerwa.gov
